Skip to content
Wm logo graphic Work Management Hub

Expert Reviews, Comparisons & Guides for Smartsheet, Monday.com, Asana, ClickUp & More

Wm logo graphic Work Management Hub

Expert Reviews, Comparisons & Guides for Smartsheet, Monday.com, Asana, ClickUp & More

  • Comparisons
  • Pricing
  • Alternatives
  • How-To Guides
  • Tools
    • Smartsheet
    • Monday.com
    • Asana
    • ClickUp
    • Notion
    • Jira
    • Wrike
    • Airtable
  • About
  • Comparisons
  • Pricing
  • Alternatives
  • How-To Guides
  • Tools
    • Smartsheet
    • Monday.com
    • Asana
    • ClickUp
    • Notion
    • Jira
    • Wrike
    • Airtable
  • About
Close

Search

Five by five heat map showing risk scores from 1 to 25 colored as low, medium and high bands
How-To GuidesSmartsheet

Smartsheet Risk Management 2026: Build a Risk Register That Scores Itself, Plus What Smartsheet AI Can (and Can’t) Do Yet

Photo of Khasim Basha Shaik
By Khasim Basha Shaik
June 10, 2026 7 Min Read
0

Home - How-To Guides - Smartsheet Risk Management 2026: Build a Risk Register That Scores Itself, Plus What Smartsheet AI Can (and Can’t) Do Yet

Smartsheet does not have a dedicated “risk module”. What it has is better for most teams: a grid you can turn into a risk register in under an hour, formulas that score each risk automatically, automations that chase owners, and dashboards that roll everything up. On top of that, Smartsheet’s AI features can now answer questions like “which high risks have no mitigation plan?” on every paid plan.

This guide walks through the build, then explains which AI features are available on which plan as of October 2026. Some features you may have read about, notably Smart Agents, are not released yet.

Table of Contents

Toggle
  • What a good risk register needs
  • Step 1: Create the sheet and columns
  • Step 2: Add formulas that score each risk
  • Step 3: Automate the follow-up
  • Step 4: Build a risk dashboard
  • Where Smartsheet AI helps with risk today
  • Which plan do you need?
  • Common mistakes
  • Frequently asked questions
    • Does Smartsheet have a risk management feature?
    • Which Smartsheet plan includes AI?
    • Are Smartsheet Smart Agents available?
    • How do I calculate a risk score in Smartsheet?
    • Can I see risks across multiple projects?
  • Related guides

What a good risk register needs

Before building anything, agree on four rules with your team. They matter more than the tool.

  1. One row per risk, one owner per risk. Shared ownership means no ownership.
  2. A simple scoring scale. Probability and impact on a 1 to 5 scale is enough for almost every project.
  3. Bands that trigger action. A score means nothing unless “High” changes how often you review it.
  4. A review date on every open risk. Registers die when nobody revisits them.

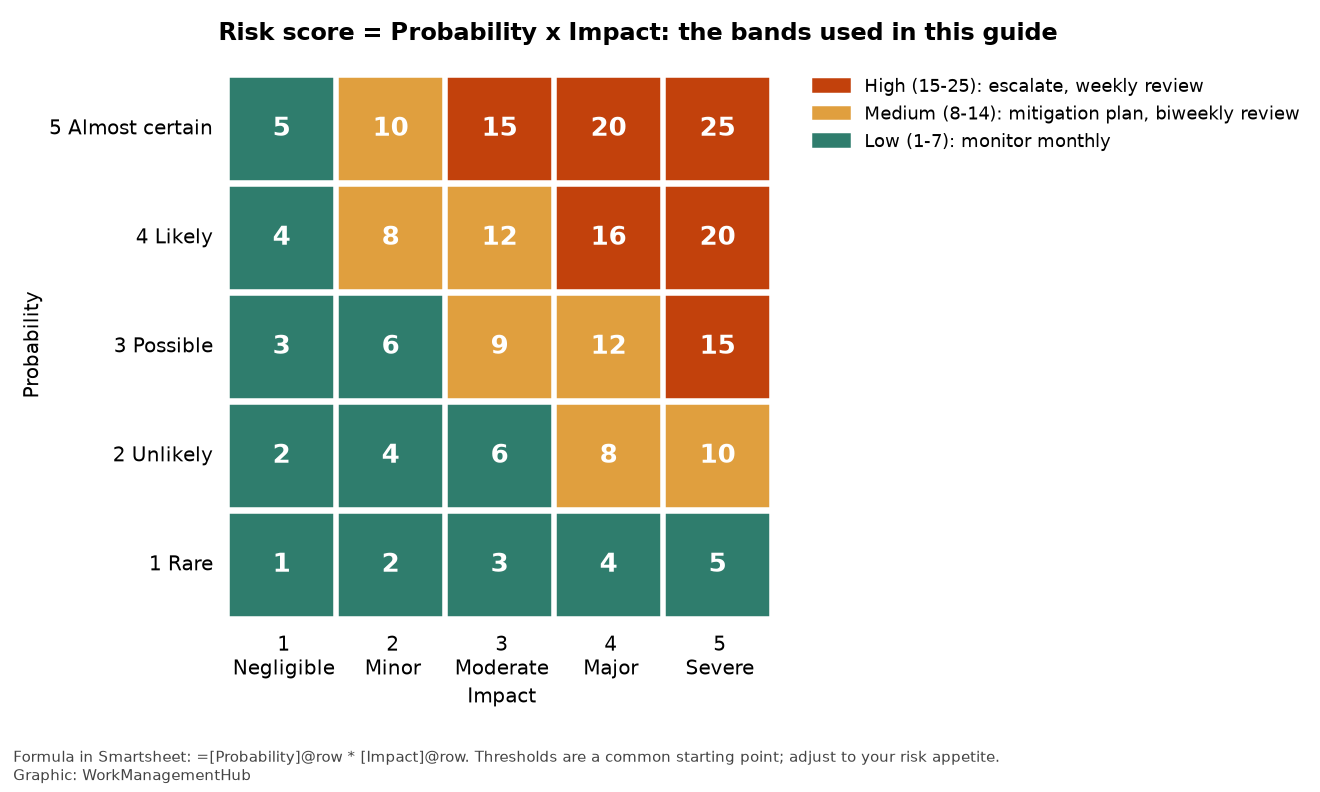

Five by five heat map showing risk scores from 1 to 25 colored as low, medium and high bands
Multiply probability by impact, then let the band decide how often the risk gets reviewed. Graphic: WorkManagementHub.

Step 1: Create the sheet and columns

Create a new sheet (or start from Smartsheet’s risk register template in the Solution Center and adjust it). Use these columns:

ColumnTypeNotes
Risk IDAuto-numberPrefix with the project code, for example ALPHA-001
RiskText/Number (primary)One sentence: “If X happens, then Y”
CategoryDropdown (single select)Schedule, Budget, Scope, Resources, Vendor, Compliance, Technical
OwnerContact listOne person only
ProbabilityDropdown 1 to 5Restrict to list values
ImpactDropdown 1 to 5Restrict to list values
ScoreText/NumberFormula, see step 2
RatingText/NumberFormula, see step 2
RAGSymbols (Red, Yellow, Green)Formula, see step 2
MitigationText/NumberWhat you will do to reduce probability or impact
StatusDropdownOpen, Mitigating, Closed, Occurred
Next reviewDateDrives reminders
ModifiedModified (date)System column, shows stale rows

Restricting Probability and Impact to list values matters: one person typing “high” instead of 4 breaks every formula downstream.

Step 2: Add formulas that score each risk

Smartsheet formulas reference cells in the same row with @row. Convert Score, Rating and RAG to column formulas (right-click a cell, then Convert to Column Formula) so every new risk is scored automatically.

Score

=IFERROR(VALUE(Probability@row) * VALUE(Impact@row), "")

VALUE turns the dropdown text into numbers; IFERROR keeps blank rows clean.

Rating

=IF(Score@row = "", "", IF(Score@row >= 15, "High", IF(Score@row >= 8, "Medium", "Low")))

RAG symbol

=IF(Rating@row = "High", "Red", IF(Rating@row = "Medium", "Yellow", IF(Rating@row = "Low", "Green", "")))

Overdue review flag (optional checkbox column)

=IF(AND(Status@row <> "Closed", [Next review]@row < TODAY()), 1, 0)

Column names with spaces need square brackets, as in [Next review]@row. If a formula returns #UNPARSEABLE, a missing bracket or a curly quote is the usual cause; our Smartsheet formulas troubleshooting guide covers the common errors.

Finish with conditional formatting: shade the whole row light red when Rating is High, and grey it out when Status is Closed.

Step 3: Automate the follow-up

Automations are what make a register live. Open Automation in the sheet’s top menu and add these four workflows:

  1. Escalate new High risks. Trigger: when Rating changes to High. Action: alert the owner and the project manager.
  2. Review reminders. Trigger: date-based, 2 days before Next review. Action: send an update request to the Owner asking for Probability, Impact, Mitigation and Status.
  3. Weekly digest. Trigger: every Monday at 9:00. Condition: Rating is High and Status is not Closed. Action: alert the sponsor.
  4. Closure sign-off. Trigger: when Status changes to Closed. Action: request approval from the project manager.

Check your plan’s limits before you add many rules. Smartsheet Pro includes 250 automations a month; Business and Enterprise are unlimited. A register with 40 open risks and weekly reminders can use around 160 of those a month on its own. The Smartsheet automations setup guide explains triggers and conditions in more detail.

Step 4: Build a risk dashboard

A dashboard is what your sponsor will actually look at. Useful widgets:

  • Metric widgets: open High risks, open risks with no mitigation, overdue reviews (use COUNTIFS in a summary sheet, for example =COUNTIFS(Rating:Rating, "High", Status:Status, "<>Closed")).
  • Chart: open risks by Category, stacked by Rating.
  • Report widget: a report filtered to High risks, showing Risk, Owner, Mitigation and Next review.

If you run several projects, build one register per project from the same template, then a single report across all of them so the portfolio view stays live. On every paid plan you can also describe the dashboard you want to the AI dashboard builder and edit the draft it produces; see our AI dashboard builder guide.

Hands typing on a laptop keyboard on a round white desk
Keep risk updates short: one line of mitigation per review is enough. Photo: WOCinTech Chat, CC BY 2.0, via Wikimedia Commons.

Where Smartsheet AI helps with risk today

Smartsheet’s AI features have changed a lot since they were announced in 2025, and plan availability is the part most articles get wrong. According to Smartsheet’s AI management overview, this is what each plan includes as of October 2026:

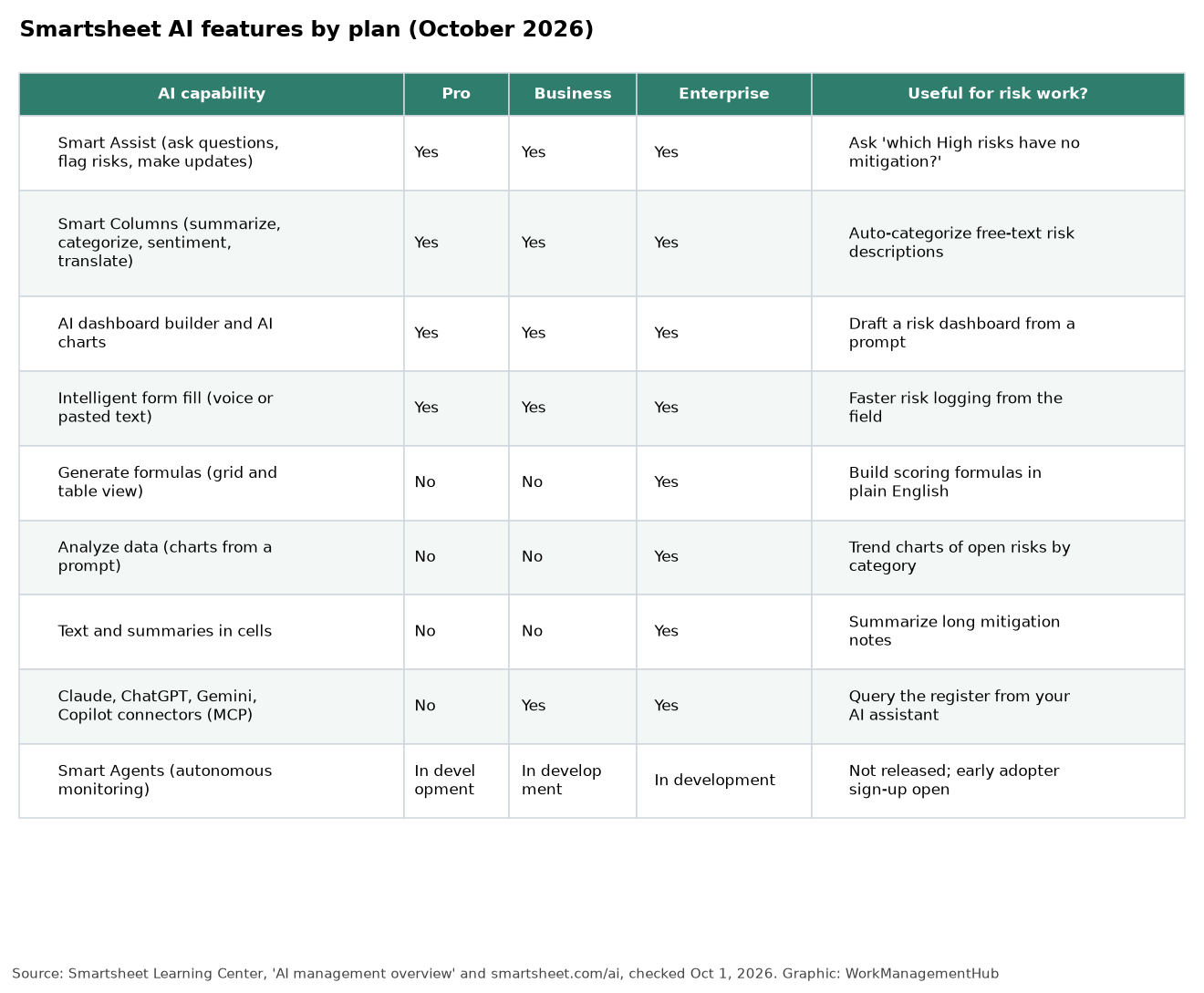

Table of Smartsheet AI features showing which are available on Pro, Business and Enterprise and how each helps risk management
Most AI features are now on every paid plan; formula generation and data analysis remain Enterprise-only. Graphic: WorkManagementHub.

On every paid plan (Pro, Business, Enterprise)

  • Smart Assist, the built-in AI assistant, can answer questions about your sheets, summarize them, flag risks and make updates. Useful prompts for a register: “List open High risks without a mitigation”, “Which owners have overdue reviews?”, “Summarize what changed in this sheet since last Monday.”
  • Smart Columns run an AI operation on every row automatically. A categorize column can sort free-text risk descriptions into your categories, which helps when many people log risks from a form.
  • AI dashboard builder creates a dashboard with up to ten charts from a text prompt.
  • Intelligent form fill lets people complete a risk intake form by voice or by pasting text.

Enterprise only

  • Generate formulas turns a plain-English request (“score each row by multiplying probability and impact”) into a formula.
  • Analyze data produces charts and metrics from a prompt.
  • Text and summaries summarizes or analyzes text in individual cells.

Business and Enterprise

  • Connectors for Claude, ChatGPT, Gemini and Microsoft Copilot via the Smartsheet MCP Server, so you can query and update the register from the AI assistant you already use. Setup is covered in our Smartsheet Claude connector guide.

Not released yet

  • Smart Agents, which Smartsheet describes as agents that will monitor programs continuously and recommend or take next steps with your approval, are still in development. Smartsheet’s AI page invites customers to apply for an early adopter program. Treat any guide that shows you how to configure them today with caution. Our Smart Agents explainer tracks what has been announced.

System admins can switch each AI capability on or off for the whole plan in Admin Center, under AI Management. Data you work with in Smartsheet AI is not used to train third-party models, according to Smartsheet.

Which plan do you need?

If you need…PlanPrice (yearly / monthly billing)
A register for one team of up to 10, light automationsPro$9 / $12 per member
Unlimited automations, external guests who can edit, AI connectorsBusiness (3 members minimum)$19 / $24 per member
Formula generation, Analyze data, advanced governanceEnterpriseCustom

Prices are from Smartsheet’s pricing page, checked October 1, 2026. For the full breakdown, see our Smartsheet pricing guide.

Common mistakes

  • Scoring without acting. If a High rating does not change the review cadence, drop the scoring and keep a simple list.
  • Too many categories. Seven is plenty. More than that and people pick “Other”.
  • Closing risks silently. Use the approval workflow so someone confirms the risk has really gone.
  • Letting AI decide. Smart Assist is good at finding gaps, but probability and impact are judgment calls for the owner.

Frequently asked questions

Does Smartsheet have a risk management feature?

Not as a separate module. Teams build risk registers in sheets, usually from a template, and use formulas, automations, reports and dashboards to score and track risks. AI features such as Smart Assist can then answer questions about the register.

Which Smartsheet plan includes AI?

Smart Assist, Smart Columns, the AI dashboard builder and intelligent form fill are available on Pro, Business and Enterprise. Generate formulas, Analyze data and Text and summaries are Enterprise-only. AI assistant connectors require Business or Enterprise.

Are Smartsheet Smart Agents available?

Not yet. As of October 2026, Smartsheet lists Smart Agents as in development, with an early adopter program open for applications.

How do I calculate a risk score in Smartsheet?

Add Probability and Impact columns with 1 to 5 values, then use a column formula such as =VALUE(Probability@row) * VALUE(Impact@row). A second formula can turn the score into a High, Medium or Low rating.

Can I see risks across multiple projects?

Yes. Build each project’s register from the same template, then create a report that pulls rows from all of them. Add that report to a dashboard for a portfolio view. For a broader look at Smartsheet’s AI tools, see our Smartsheet AI features deep dive.

Sponsored

OneSMAR for Smartsheet Teams - Available on the App Store

Related guides

Smartsheet Portfolios and Scenario Planning: A 2026 Setup Guide
Smartsheet
Smartsheet Portfolios and Scenario Planning: A 2026 Setup Guide
Smartsheet Pricing 2026: Pro vs Business vs Enterprise, Who Counts as a Paid Seat, and Add-On Costs
Pricing Guides
Smartsheet Pricing 2026: Pro vs Business vs Enterprise, Who Counts as a Paid Seat, and Add-On Costs

Smartsheet or Microsoft Project? The 2026 Licensing Math
Smartsheet
Smartsheet or Microsoft Project? The 2026 Licensing Math
Photo of Khasim Basha Shaik
Author

Khasim Basha Shaik

Khasim is a work management expert and entrepreneur with a deep passion for project management tools. He works hands-on with platforms like Smartsheet, Monday.com, Asana, ClickUp, Jira, Notion, Wrike and Airtable every day, and loves automating workflows to save teams and customers a ton of time. On WorkManagementHub he shares practical setup guides, honest tool comparisons, and real-world troubleshooting drawn from daily use.

Follow Me
Other Articles
Table comparing Airtable and Asana on core model, free plan, paid plan prices, billing rules and strengths
Previous

Airtable vs Asana 2026: Pricing, AI Features & Which Is Right for You

Table comparing four ways to get Asana data into reports: Asana dashboards, the Power BI connector, CSV export and third-party connectors
Next

Asana and Power BI in 2026: How to Set Up the Official Connector, Build a Project Dashboard and Fix Common Errors

No Comment! Be the first one.

    Leave a Reply Cancel reply

    Your email address will not be published. Required fields are marked *

    KB
    Khasim Basha Shaik

    Khasim is a work management expert and entrepreneur with a deep passion for project management tools. He works hands-on with platforms like Smartsheet, Monday.com, Asana, ClickUp, Jira, Notion, Wrike and Airtable every day, and loves automating workflows to save teams and customers a ton of time. On WorkManagementHub he shares practical setup guides, honest tool comparisons, and real-world troubleshooting drawn from daily use.

    About Work Management Hub →

    Popular reviews & guides

    • Table matching ten team types to the project management tool to start with, a runner-up and the reasonBest Project Management Software 2026: 10 Tools Compared by Team Type, Real Monthly Cost and the Limits That Matter
    • Team meeting around a long conference table with laptops openJira Pricing 2026: Standard vs Premium, Annual Tiers and the Oct 13 Increase
    • Developer working on a laptop with code on screen while holding a phoneJira Slack Integration 2026: Setup, @Jira Tickets and Channels Without the Noise
    • Laptop covered in developer stickers on a deskLinear vs GitHub Issues (2026): Who Should Track the Work?
    • Person typing on a laptop at a small round tableLinear-GitHub Sync Broken? Fix Every Failure Mode
    • Three people collaborating around a laptop at a meeting tableGitHub Stacked PRs Are GA: What Changed Oct 6, 2026 (and How to Roll Them Out)

    Browse by tool

    • Smartsheet33
    • Monday.com28
    • Asana33
    • ClickUp30
    • Notion28
    • Jira31
    • Wrike16
    • Airtable16
    • Integrations12

    Sponsored OneSMAR – Everything you need for Smartsheet in one place

    Independent reviews, comparisons, and hands-on guides for work management tools — Smartsheet, Monday.com, Asana, ClickUp, Notion, Jira, Wrike, and Airtable — written from daily, real-world use of these platforms.

    Tools We Cover

    • Smartsheet
    • Monday.com
    • ClickUp
    • Asana
    • Notion
    • Jira
    • Wrike
    • Airtable

    Company

    • About Us
    • Contact Us
    • Privacy Policy
    • Terms of Use
    • Disclaimer
    • Affiliate Disclosure
    Copyright 2026 — Work Management Hub. All rights reserved. Blogsy WordPress Theme
